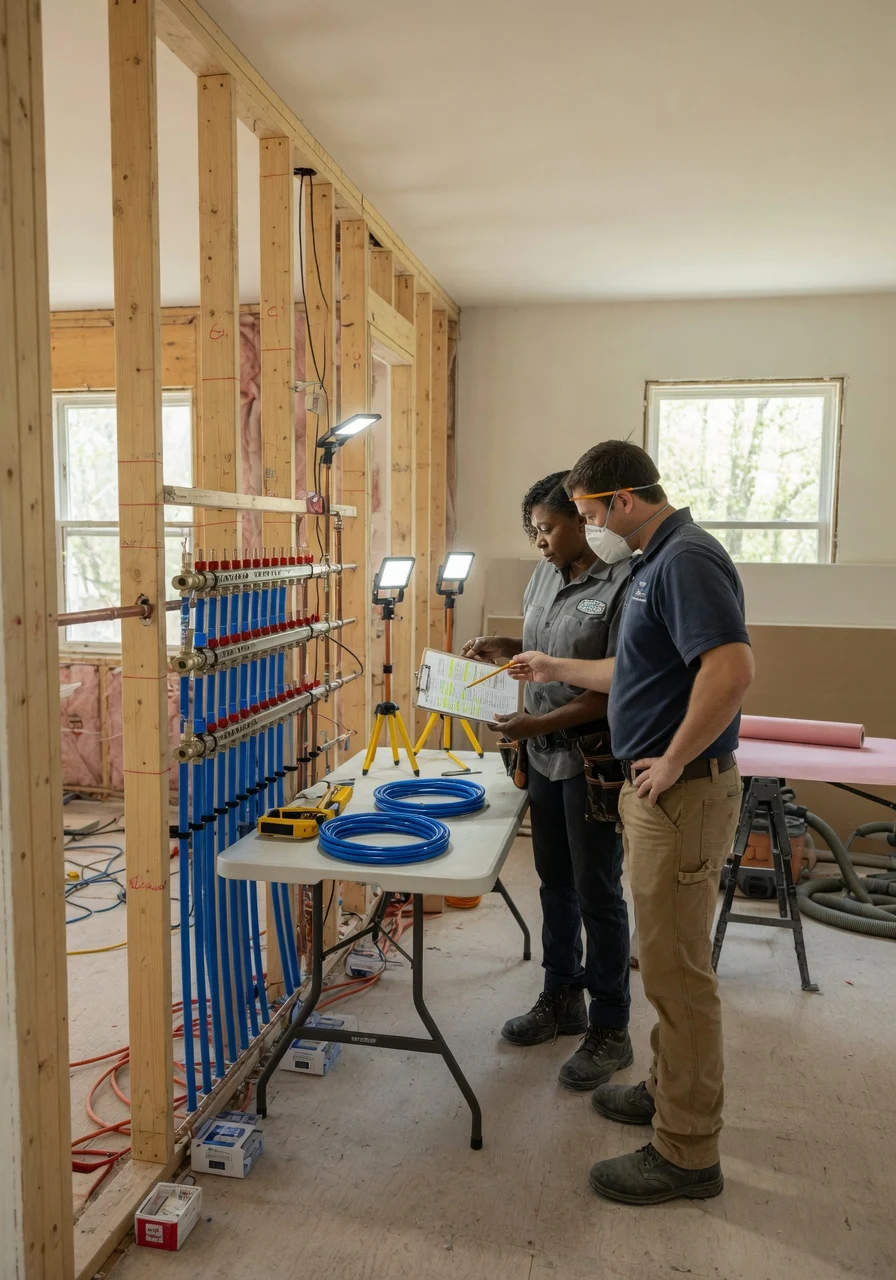

Plumbing needs to be sequenced early because it sits on the critical path. If rough-in is late, framing inspection, insulation, drywall, tile, cabinets, and final inspection all move. If sewer work is delayed by wet clay soil, the whole project can stall.
This is especially true in Davidson County, where Metro Nashville permit and inspection timing can affect the schedule.
The Spring Problem
Spring renovation looks simple on a spreadsheet. In the field, you get:
- Wet crawlspaces
Nashville's expansive clay is easier to talk about than work in. Wet clay slows excavation and makes sewer work messier. Drying time matters.
Ideal Plumbing Sequence
For a typical Nashville flip:
1. Pre-close camera and pipe ID.
Do not schedule plumbing rough-in after drywall has a date. Schedule drywall after plumbing passes rough inspection.
2026 Spring Plumbing Schedule and Cost Table
The duration assumes materials are selected and access is ready. Waiting on vanity specs or appliance BTU data can stop the job.
Decisions Needed Before Rough-In
Your plumber needs decisions before walls close:
#
Fixture decisions
- Kitchen sink location
Changing these after rough-in costs money and time.
Spring Sewer Work
Spring rain exposes drainage problems and slows excavation. If your sewer camera shows a belly, root intrusion, or clay lateral failure, schedule repair early.
Wet soil can affect:
- Excavation speed
For East Nashville and Madison properties with older laterals, do not push sewer work to the end. A finished renovation with a known sewer defect is asking for a buyer retrade.
Crawlspace Conditions
Spring crawlspaces in Nashville can be wet, tight, and slow. If supply lines run through a crawlspace, clear debris and coordinate access before the plumber arrives.
Investors can save time by:
- Removing old debris
A plumber crawling through mud under an East Nashville bungalow is not moving at new-construction speed.
Permit Timing
Metro Nashville requires permits for many plumbing installations, fixtures, water heaters, sewer work, and gas work. The exact permit path depends on scope, but the investor takeaway is simple: decide early and pull permits before rough-in becomes the schedule bottleneck.
Permit problems usually come from unclear scope. If the plan changes from "replace fixtures" to "move kitchen, add bath, convert garage, install tankless," the permit scope changes too.
Coordination With Other Trades
Plumbing conflicts most often with framing, HVAC, electrical, cabinets, tile, and concrete.
Coordinate:
- Joist boring and structural limits
The plumber does not need every finish selected, but rough-in needs dimensional certainty.
Materials and Lead Times
Spring is also when small material delays become schedule problems. Common fixtures are usually available, but specialty shower valves, wall-mounted faucets, tankless vent kits, black trim packages, and certain freestanding tub drains can take longer. If a fixture has a rough-in body, the plumber needs it before walls close.
Do not order only the pretty trim. Order the valve body, drain kit, mounting hardware, and manufacturer specs. I have seen a bathroom sit for a week because the investor had the shower trim in hand but not the valve that actually goes in the wall.
For rental-grade work, standardize parts and buy early. For premium Green Hills, Brentwood, or Franklin projects, confirm rough-in dimensions before framing is locked.
Seasonal Inspection Strategy
Do not wait until Friday afternoon to call for a rough inspection on a spring project. If drywall is scheduled for Monday and the inspection fails for one missing nail plate, unsupported pipe, or incomplete test, every trade behind plumbing gets pushed. Build at least one inspection correction day into the schedule.
On sewer work, watch the weather. A trench repair planned during a heavy rain week can become slower, messier, and more expensive to restore. If the sewer defect is known before closing, schedule it early enough that weather does not control your listing date.
Nashville Investor Timeline Example
For a 1,600-square-foot East Nashville flip:
That timeline works when decisions are made early. It fails when the investor changes the shower layout after rough-in.
Bottom Line
Spring renovation in Nashville rewards investors who plan plumbing before the project gets crowded. Camera the sewer early, identify bad pipe, pull the right permits, make fixture decisions, and put rough-in ahead of drywall.
If your spring flip is in East Nashville, Antioch, Madison, Brentwood, Green Hills, Franklin, or Murfreesboro, call Luke Lays Pipe at (734) 748-4831 before demo starts. We will sequence the plumbing so it does not become the reason your renovation misses market.
Questions About Your Nashville Project?
Luke Lays Pipe provides flat-rate plumbing for Nashville house flips and investors — repiping, sewer repair, water heaters, and more.
Get a Free Quote
Flat-rate pricing for Nashville flips and investors.
(734) 748-4831 Send a Quote RequestInvestor Tool
Flip Plumbing Cost Calculator
Estimate repiping, sewer, water heater, and permit costs before you make an offer — built for Nashville investors.
Estimate My Budget →
